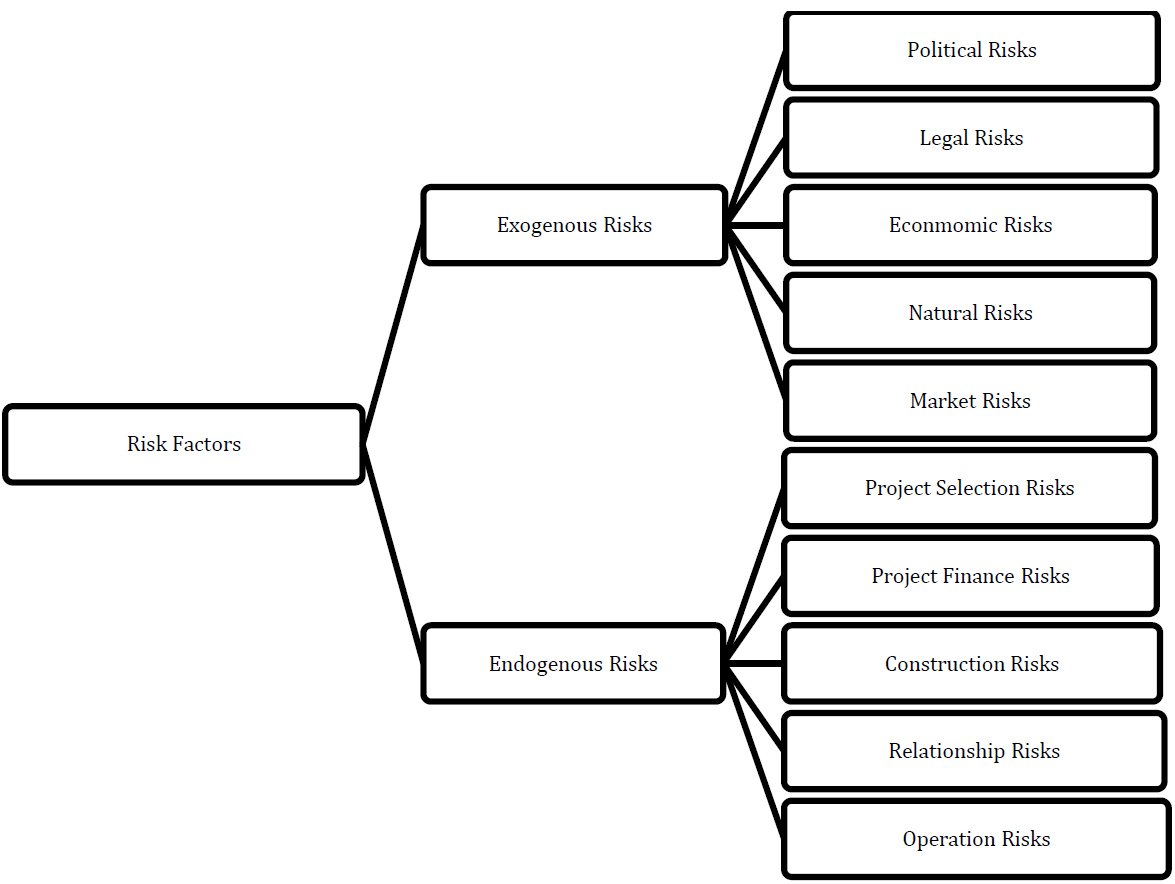

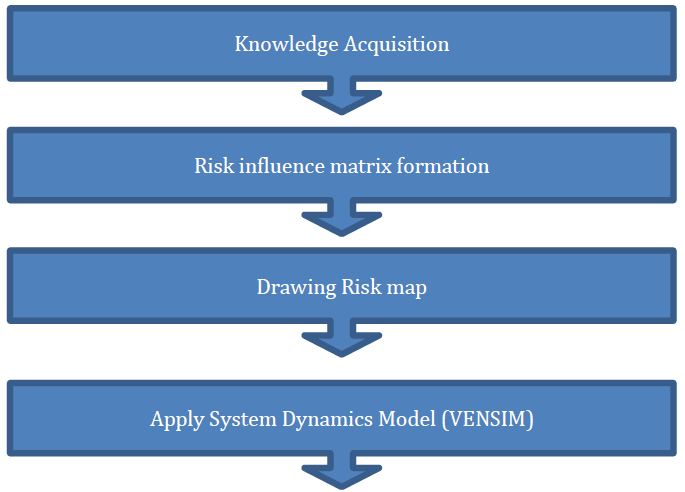

Volume 7, Issue 4 (April 2020), Pages: 107-112 ---------------------------------------------- Original Research Paper Title: Impact of most correlated risk factors into actual construction price in PPP projects Author(s): Yahya Alfraidi 1, *, Saleh Mohammed Alzahrani 2 Affiliation(s): 1Architecture Engineering Department, College of Engineering, Hail University, Hail, Saudi Arabia * Corresponding Author. Corresponding author's ORCID profile: https://orcid.org/0000-0002-8654-6797 Digital Object Identifier: https://doi.org/10.21833/ijaas.2020.04.014 Abstract: The basis of the formulation of most of the Public-Private Partnerships (PPP) is the reasoning that the public authority authorizes the design, construction, operation, maintenance, and funding of a public infrastructure project from a private group through a single contractual agreement. In general, PPP project risks consist of developing and building a new asset and ensuring that it remains functional for many decades. Exceeding the cost and time limits is possibly the most severe implication of risks throughout the construction period. Such events are the most extensively discussed situations in value for money risk analysis. There are changes in the sources of risk across the life cycle of a PPP project. In certain situations, the importance of construction and development risks in infrastructure projects is quite high. It is believed that projects pertaining to IT, rehabilitation/refurbishments, and complex agencies’ interaction have considerably greater risks compared to other assets. PPP construction risks have been categorized by Standard and Poor in accordance with the kind of assets, indicating that the funding bodies acknowledge the presence of a relationship between construction risks and kinds of PPP assets. Usually, all price distress has to be covered by the public sector from these risks in conventional procurement. There is sufficient evidence to imply that in a few of the projects that are completed under the public procurement systems, public distress is normal. The effect of risk factors on the precise construction price in PPP projects will be determined in this paper. In addition, it will present the correlation between the risk factors and the precise construction price units in PPP projects. © 2020 The Authors. Published by IASE. This is an Keywords: Impact of risks, Public-private partnership, Price overrun Article History: Received 20 November 2019, Received in revised form 26 January 2020, Accepted 28 January 2020 Acknowledgment: No Acknowledgment. Compliance with ethical standards Conflict of interest: The authors declare that they have no conflict of interest. Citation: Alfraidi Y and Alzahrani SM (2020). Impact of most correlated risk factors into actual construction price in PPP projects. International Journal of Advanced and Applied Sciences, 7(4): 107-112 Figures Tables No Table ---------------------------------------------- References (11)
|
